Roxy Robertson, Environmental Scientist, WSB

Uncovering the potential issue

In the past few years, there has been a push to utilize renewable energy resources. In Minnesota and other states, there has been legislation to require some of this renewable energy to come from solar. According to the Solar Energy Industries Association (SEIA), Minnesota ranks 13th in the nation for megawatt production, producing 1,140 MW of energy from solar. This push for solar has resulted in the development of small-scale and community solar gardens which construct panels across a variety of landscapes, including low-lying wetland areas.

In Minnesota, there are rules and regulations for impacts to wetlands that include regulations surrounding the placement of a structure in a wetland. These rules are outlined in the Wetland Conservation Act (WCA). The WCA allows the construction of some panels in wetland areas depending on the type of impact, but regulation of these impacts is highly variable throughout the state due to lack of specific language regarding whether solar panels truly cause wetland impacts. There are opinions that suggest that the installation of solar panels within wetlands affect the quality of the wetland vegetation under the panels over time. In addition to these regulations, the Board of Water and Soil Resources (BWSR) also has standards that encourage developers of solar fields to plant vegetation that benefits pollinators.

Currently, there isn’t any research that explores the direct impact of solar panels on wetland vegetation. From small community solar gardens to large utility scale solar gardens, the energy generated can benefit communities, but what is the impact on the underlying vegetation? If solar panels are placed in a degraded wetland such as a farm field, would the installation of panels and native seed mixes improve the quality of wetland vegetation?

Where is the research?

The lack of research explaining direct impacts that solar installations have on vegetation is a challenge for scientists and engineers. Through communication with regulators and developers, we have discovered there is room for growth and study in this area, and it is a topic that needs continued exploration. This data gap has led us to develop our own vegetation studies at community solar gardens. This data is imperative if we are to continue to rely on solar energy resources. Without current guidelines that outline negative or positive effects, we are unsure of the long-term overall environmental impacts to vegetation quality under solar panels, which in turn affects the quality of natural habitat and functional benefits provided by the landscape. How do energy companies know if they are impacting the environment that surrounds solar gardens? Pursuing funding for extensive research has been challenging for those who are curious about the effects of installation of solar technology on surrounding vegetation. Even after preliminary research, many questions remain surrounding the shading of solar panels and vegetation, direct impacts, and long-term effects.

What does this mean for the future?

SEIA projects that Minnesota’s solar energy consumption will grow by 845 megawatts within the next five years. Financial support to continue this research is necessary and will allow scientists to uncover data at solar sites that does not yet exist. With this data, we can better understand the environment, impact of projects on vegetation, and develop tools to distinguish impacts. Developers looking for land will better understand the risks involved when building a solar garden on or near a wetland. As need and desire for renewable energy increases, more energy companies will implement solar. However, if we are not aware of the impacts solar gardens have, how will we know if there is an additional cost to the environment? Knowing areas to avoid allows companies to be certain of regulations, save time and money, and limit impacts to surrounding wetlands. We are continuing to complete research to better understand the impacts and benefits of solar arrays on underlying vegetation.

Roxy is an environmental scientist and certified wetland delineator. She has a master’s degree in ecology and is a Certified Associate Ecologist . She has completed numerous wetland delineations and has experience with wetland monitoring, ecological restoration design, environmental site assessments, field research, biological surveys, ArcGIS mapping, and GPS Trimble.

Molly Just, Sr Planner, WSB

So, your comprehensive plan is done – and everyone is breathing a big sigh of relief. Now what?

A community’s comprehensive plan includes recommendations on land use, housing, and other areas that are described and enforced by that city’s zoning ordinance and subdivision ordinance. Without updating the zoning ordinance many planning goals may not be attainable. Zoning is important to promote and manage growth and to help residents and businesses manage expectations about what they and their neighbors can do with their property. Simply put, you can’t attain the development goals established in a comprehensive plan without a zoning ordinance.

A sense of relief and accomplishment at the end of the comprehensive planning process is understandable; it can take years to update a comprehensive plan. As a former local government planner, I have been asked many times if a plan will just “sit on the shelf.” This often stems from a lack of ability to build the plan. Zoning means different things to different stakeholders. For developers, zoning is a building tool. For residents, it is a tool used for protection from the unknown. For local government, it is a tool to promote the prosperity, health, and welfare of the whole community. For planners, zoning is a tool to achieve the plan goals. Turning a comprehensive plan into a reality can be largely based on the zoning ordinance. An update to the zoning ordinance should be incorporated when updating a comprehensive plan.

Here are four reasons to update your zoning ordinance:

  • An update leads to increased buy-in from elected officials and community stakeholders.  Planning is a visionary process. If stakeholders know that the zoning comes next, they may be more likely to participate and stay involved. The zoning ordinance puts plans into action.
  • It helps ensure the zoning work will be completed and budgeted for in advance of planning fatigue that can overwhelm the late phases of updating the comprehensive plan.
  • The comprehensive plan visioning may be stronger with the knowledge that zoning should occur immediately following completion. The comp plan will be more targeted to the conditions of the community and supported by stakeholders and elected officials. In other words, visions are rightsized to the community.
  • The plan visions may be sooner realized. Oftentimes planning fatigue and competition for staff time and resources result in zoning updates being pushed off for months or years, potentially resulting in legal challenges or extended project timelines.

And beyond just planning for the zoning update, here are six reasons to update your zoning ordinance:

  • Legal protection.  Zoning decisions that have no basis in the comprehensive plan are more successfully challenged in court.  There must be a rational basis for zoning decisions and requirements.  Additionally, cities in the Twin Cities metropolitan area must comply with the Metropolitan Land Planning Act which imposes certain mandatory zoning and regulatory requirements and requires that zoning directives harmonize with and not contradict the comprehensive plan.
  • To reflect federal and state law pertaining to land use and zoning.  For example, how we regulate non-conformities has changed in Minnesota, with local authority over non-conformities weakening.  Also, legal decisions regarding signage impact how local government reviews sign applications.
  • To incorporate plain language and resolve internal conflicts that are the result of decades of incremental updates.  The use of plain and clear language to define uses and terms strengthens the legal standing of ordinance interpretations.
  • To address confusing concepts that have led to inconsistent application of code.  Modern zoning codes use graphics to illustrate concepts such as setbacks, lot coverage, and floor area ratio.
  • To adapt to societal changes that conflict with narrow use categories and single-use zoning, such as allowing home offices, businesses, accessory units, and accessory structures within homes and on single-family lots.
  • To incorporate best practices in land use and development that focus on how a building fits into its context and ways to mitigate use conflicts rather than narrowly legislate use of private property.

Although, there are many factors that determine how quickly a comprehensive plan can become a reality, zoning is certainly not a factor to discard.

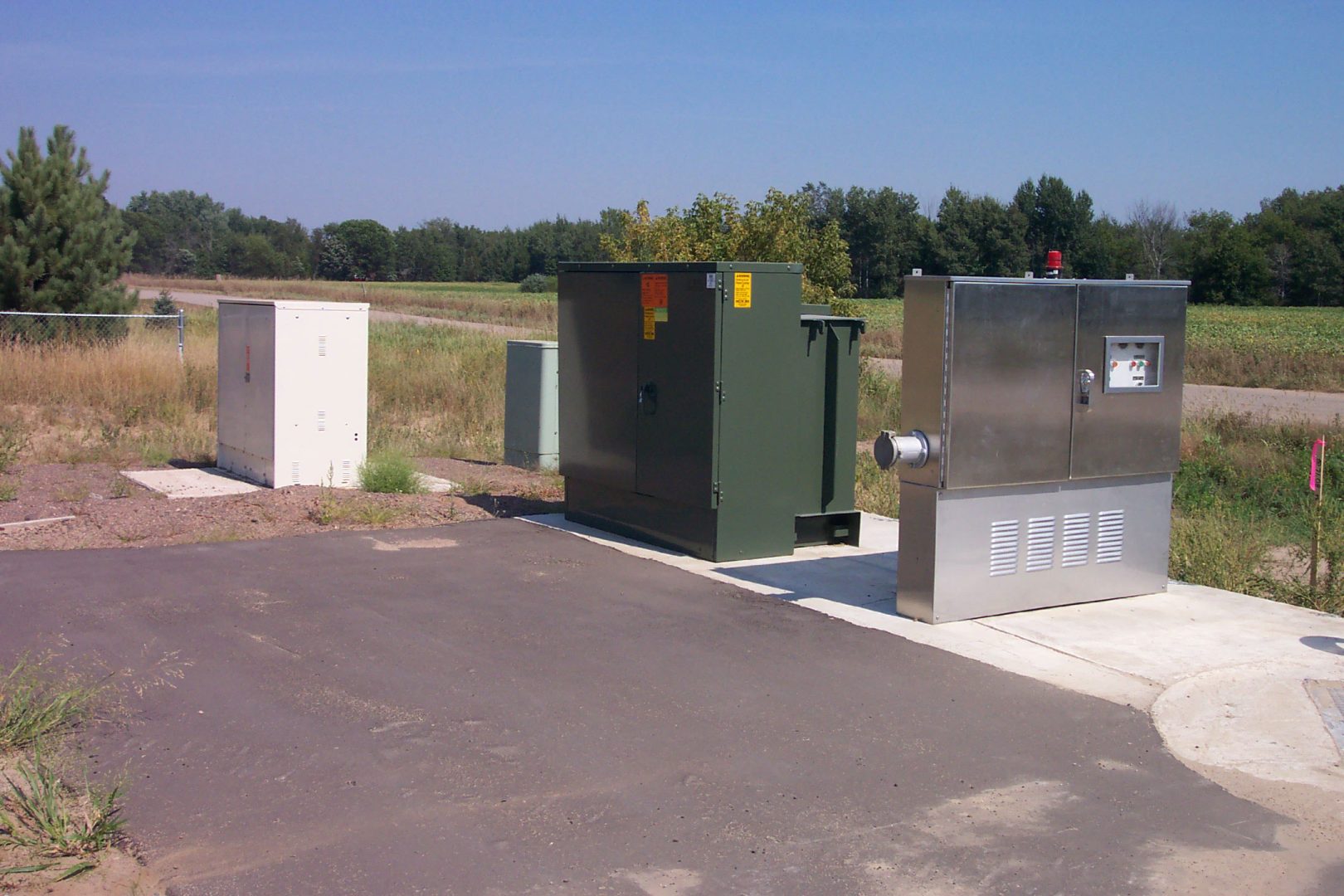

As infrastructure ages, you will need to prioritize which items to fix first. You need to determine which items to do this year and which items can wait for future plans. How do you know when it is time to put a lift station at the top of the list? Below are 5 signs that your lift station is nearing the end of their usable life cycle.

1. Clogged Pumps – Have your maintenance crews been spending an inordinate amount of time and resources addressing clogged pumps? Rags, sanitary products, and many other items find their way into your city’s sanitary sewer, but cannot be passed by the old style impellers. It might be time to upgrade your pumps to modern non-clog impellers to address this maintenance nightmare.

2. Increased Pump Runtimes – Over time, pumps lose their efficiency causing them to generate less flow at lower velocities. This can cause solids to settle in the forcemain and exacerbate the pump inefficiencies. Compare your electricity bills over time. If the number of kilowatt hours used has gone up, it might be time to dig into the issue.

3. Electrical & Communication Failures – Old starters, leaking mechanical seals, electrical service changes: these items can cause tripped circuit breakers and blown fuses. If your SCADA system isn’t communicating these failures to maintenance staff, you might find out from an angry resident with sewage backup in their basement. Electrical and communication upgrades will help your staff maintain real-time status updates and put your mind at ease.

4. Degraded Concrete, Piping & Equipment – Sanitary sewage can generate corrosive hydrogen sulfide (H2S) gas that chews up the lift station concrete, pump rails, piping, hatches, and valves. Ensuring proper pump cycles and providing mixing to break up gas producing materials in the lift station can help reduce gas generation, but it may also be necessary to coat the concrete with a corrosion resistant barrier and replace lift station equipment with more robust materials. Have the field crew take photos for you to review.

5. Safety – Are your lift station hatches equipped with fall protection? Are your workers using tripods with harnesses for lift station access, or are they relying on deteriorated manhole steps? Review the safety features of your lift stations and make sure your crew has the right equipment to do their job safely. Lift stations are a very hazardous environment, but simple safety features and protocols can make all the difference.

If you are experiencing any of these issues or want more information, we can help.

Brandon Movall, Graduate Engineer, WSB

Road reconstruction projects affect residents of all cities, from large metropolitan areas to small rural centers. While residents are very familiar with the sight of bright orange cones and excavating machines that are shown for a few months in the summer, few know the full amount of work that goes into improving roads and public utilities the rest of the year. Here is a season by season breakdown of how a road reconstruction project comes to life:

Summer/Fall

The summer/fall season is when work on a specific project typically begins for the upcoming construction season, with the start of preliminary design. Depending on the size and complexity of the project, preliminary design can begin months or even years earlier than this time frame.

The preliminary design begins by collecting extensive information on the existing conditions of the public infrastructure in the project area. This can be done through a topographic survey of the area, taking geotechnical readings on the materials in the area, and even reviewing asset management systems or old plan sets for the project area.

Based on the information gathered, the project team (typically consisting of transportation and municipal engineers) can identify improvements needed within the project area. The team then provides a preliminary overview of proposed improvements to the project owners, private utility companies such as gas or electric that could be impacted, residents, business owners and other stakeholders in the project area. At this point, public engagement becomes critical to connect with the owners, companies, and residents to solicit feedback on the proposed improvements and gather additional information on existing conditions. This feedback can be achieved through neighborhood meetings, showcasing visualizations, and conducting community surveys.

After gathering feedback, the project team presents the proposed infrastructure improvements along with estimates on costs and schedule to the project owners, and, if the project is still supported, begins final design.

Fall/Winter

The fall/winter season is dedicated to final design of the project. The team (supported by site & landscape designers, water resource engineers and wastewater engineers) completes final design documents that specialists in infrastructure construction techniques will use build the project. These documents will complete the city’s vision for the project while ensuring it is properly engineered and safe for residents. The design includes not only the pavement that residents drive on, but also all of the public utilities in the project area, such as storm sewer, sanitary sewer and watermain.

During this time, the project will also be reviewed by permitting agencies that have jurisdiction over certain aspects of the project. These agencies, such as a county or state transportation agency, may have jurisdiction over neighboring roads. Other agencies, like a state departments of natural resources, may review the project for environmental regulations within the project area.

Once the plans and specifications are complete, the project team will share the finished design documents with the project owner. The project is then authorized to be bid for construction.

Winter/Spring

The spring season is used to bid the project and prepare for construction. After the project is authorized to be bid, a notice goes out to contractors notifying them of the project and providing them access to the plans and specifications. If a contractor is interested in constructing the project, they submit a set of documents to the project owner. These documents include insurance information, proof of bonds, and their bid of how much they believe it will cost to construct the project. At an arranged time, a contractor will be selected from those that submitted a bid.

Once a contractor has been selected, project management and construction administration begins. Preliminary construction meetings are held with the project owners, the project team, and other stakeholders, to prepare for the upcoming construction of the project.

Spring/Summer

After the preliminary and final designs are complete, construction -the most visible stage of a project – can begin during the spring/summer season. During this time, the project team monitors contractor progress on the project, and ensures that the construction is being done according to the plans and specifications that were prepared in the fall/winter. This monitoring consists of a variety of activities that include construction material testing, environmental compliance, and more.

Because the winter season is often the longest in the Midwest, the time frame for construction is extremely short. To protect the final product, some projects require contractors to wait until after winter to finish minor paving and restoration work during the following spring/summer season.

Once all of the work is complete and accepted by the project owner, the contract is finalized and closed out. Usually a maintenance period is required of the contractor, during which time they are responsible to address any workmanship or materials defects which are identified following close out.

At this point, the project is considered complete. The project owner is responsible for ongoing maintenance and repair of the infrastructure through their Public Works Department. The new seasonal cycle begins with the next project that was prioritized or identified within that community’s Capital Improvement Plan or similar planning document. Learn about how WSB can assist your community with any or all of these project cycles by visiting https://www.wsbeng.com/expertise/community/ or clicking on any of the linked services above.

Brandon is a Graduate Engineer with WSB and serves as the assistant city engineer for the City of Sunfish Lake, MN. He is experienced with reviewing developer and residential land development plans and management of cities’ Municipal State Aid Systems (MSAS) through the Minnesota Department of Transportation (MnDOT).

Roxy Robertson, Environmental Scientist, WSB

Solar production in Minnesota has seen dramatic increases in the past few years and continues to grow across the state. With this rapid growth comes challenges about how to regulate the installation of panels at a local level. According to the Solar Energy Industries Association (SEIA), Minnesota has already invested $1.9 billion on solar and additional growth is projected at 834 megawatts over the next five years. The installations of solar “farms”, vast arrays of solar panels, can be seen throughout the state and can generate up to a megawatt of electricity each. Development of these sites often requires large, vacant parcels which may also support natural habitats such as wetlands.

The development application process for these solar farms can be challenging for municipalities, especially those who act as the local government unit (LGU) for the Wetland Conservation Act (WCA). Developers must work collaboratively with LGUs to demonstrate a sequencing process that shows how their projects are avoiding, minimizing, and if necessary, replacing unavoidable wetland impacts. Under the WCA rule, the installation of posts and pilings from solar panels has traditionally not been considered a wetland impact if they do not significantly alter the wetland function and value. But, as the solar industry grows, LGUs have had questions about whether the installation of solar panels may lead to loss in wetland quality over time which would be a violation of WCA. A strong measure of wetland quality comes from the diversity of the plants within the wetland, factors like shading from panels and disturbances from construction may lead to conversion of the wetland vegetative community, and subsequently, the wetland quality. Loss of wetlands and wetland quality has overlapping effects on drinking water, lake and stream health, native wildlife, soil heath, and pollinators, all of which are important to our Minnesota ecosystems.

So why does this affect you? Many municipalities act as the LGU responsible for implementing WCA. LGUs, alongside other regulating agencies, have been struggling to make impact determinations for sites that install panels in wetlands because there is little data available that addresses the future outcomes of these natural areas. There is a growing need for baseline data about how the quality of wetland vegetation changes throughout the solar development process. If data were available, LGUs could use these as a basis for making determinations.

Having baseline data about wetland vegetative quality under solar panels is beneficial to both regulators and developers. Regulators will have a scientific basis for making wetland impact determinations within their jurisdiction and developers will see more consistency across municipalities during the permitting process. We may see that wetland quality improves under solar panels in certain circumstances through the planting of native vegetation upon completion of development. In other scenarios, wetland quality may decrease if the existing wetland was of higher quality prior to development.

WSB has started an exciting initiative to collect this baseline data at various solar sites in Minnesota. In 2019, environmental scientists at WSB surveyed wetland vegetation under existing or planned solar panels at four solar farms in varying stages of development. Additional data collection at these sites is planned for the summer of 2020. WSB is in the process of developing a Legislative-Citizen Commission on Minnesota Resources (LCCMR) grant application to expand this research in 2021 to more sites across the state and to include other metrics that may influence vegetation such as fixed-tilt or tracker panel types. Support of this research from municipalities will be important for the LCCMR application process and we encourage you to join us in the process through letters of support, in-kind hours, monetary support, or providing access to solar farms within your area. It is an exciting time in the renewable energy industry and WSB is committed to helping advance the clean energy market in a way that is sustainable to our Minnesota environment that we all cherish.

Roxy is an environmental scientist and certified wetland delineator. She has a master’s degree in ecology and is a Certified Associate Ecologist. She has completed numerous wetland delineations and has experience with wetland monitoring, ecological restoration design, environmental site assessments, field research, biological surveys, ArcGIS mapping, and GPS Trimble.

Alison Harwood, Director of Natural Resources, WSB

As someone who has been on both the regulator and applicant side of the table, I understand that wetland permitting can seem like a complicated task, involving multiple review agencies and months of careful planning. I’ve witnessed frustrated project developers after growing impatient with the process, and concerned regulators who feared the appropriate steps to minimize impacts were not taken. However, if anticipated correctly, the permitting process can be smooth and painless.

As we approach growing season, it is helpful to understand the project development steps for areas that feature wetlands – even if you don’t expect to impact them.

  1. Identify wetlands.

This should be one of the first steps taken during project planning. A desktop-level delineation can be completed anytime by a wetland professional and is used to determine the potential for wetlands on the project site.

Do not assume your site does not have wetlands.

Depending on the results of the review, an onsite wetland delineation may be needed, which can only be completed during specific times of the year (i.e. growing season). Missing this window can cause delays in your project or force you to make design assumptions based on inaccurate data, which can increase the risk for redesign once field data is available.

From the beginning of a delineation to having approved boundaries can take several weeks or months, so advanced planning is essential if the project development indicates a shorter construction timeline. Assigning a trained wetland delineator is important during this step to ensure project boundaries are accurately identified and reported to local reviewing agencies. Mismanagement at this stage can result in extra work and time delays. Once the boundary data is collected, project developers can update the design plan and determine if wetland impacts will occur.

  1. Examine potential impacts early.

Wetland impact approvals should always be obtained before you begin local project planning (i.e. plat approval) and identifying potential impacts early in design is key. This ensures that wetland regulation agencies are afforded the opportunity to review site plans and suggest ways to minimize impact and reduce the developer’s risk of costly design changes or permit denial.

  1. Contact local wetland regulation agencies.

If impacts are expected, it’s a good idea at this point to inform the local wetland regulation agencies and plan a pre-application meeting. There are several agencies that regulate wetlands and keeping all informed is vital to ensure the permitting process stays on track. The most common agencies that are involved include the Wetland Conservation Act (WCA) Local Government Unit (LGU), US Army Corps of Engineers (USACE), Department of Natural Resources (DNR), and in some areas of the state, Watershed Districts (WD) or Watershed Management Organizations (WMO). Learn more about these wetland regulation agencies.

The amount of impact proposed for a project can affect the length of the review process. The following approval timelines can be used as a guide:

Agency

Permit Type Days to Approval
WCA LGU Wetland Impact Replacement Plan 60 days
DNR Public Waters Permit 60 days
USACE* Nationwide or General Permit (<0.5 acre) 60 – 90 days
Letter of Permission (0.5 – 3 acres) 4 – 9 months
Individual Permit (> 3 acres)

9 – 24 months

*Permit thresholds reported are for non-transportation projects.

Approvals through Watershed Districts Management Organizations vary, so project developers should refer to local guidelines for application and review timelines.

Often, the reviews described above are independent of each other. Approvals from one agency (ie: WCA LGU) does not eliminate the need for approvals from other agencies (ie: DNR). While the agencies may communicate with each other, developers are ultimately responsible for ensuring permit applications are received by each individual agency.

Below is a general timeline of project tasks that should be completed prior to getting approval by local agencies.

Task Completion in Months (Prior to Local Plan Approval)
Wetland Delineation 8 months prior
Delineation Approval 6 months prior
Permit Pre-Application Meeting 5 months prior
Permit Submittal* 4 months prior
Permit Approval 1 month prior

* Assumes USACE General or Nationwide Permit.

Local ordinances should also be reviewed to ensure that all water resource-related requirements are being met. For example, some cities have wetland buffer setbacks that must be incorporated into the project design.

With proper planning, the wetland permitting process can be smooth and transparent. A little work in the beginning to identify the potential for wetlands can save the project manager from redesign and time delays that derail project progress.

By Meghan Litsey, Sr. Environmental Scientist, WSB

Municipal Separate Storm Sewer System (MS4) communities tend to dread the words “compliance audit”. The auditing process can be intimidating, but it can also provide an opportunity to highlight positive aspects of your community. Local agencies like the Minnesota Pollution Control Agency (MPCA) can offer insight about the process and help generate ideas for your MS4 program. Right now, the MPCA is conducting regular compliance audits despite the new MS4 permitting that is anticipated to take effect later this year.

So, it’s important to keep your MS4 program up to standard and audit-proof all year round.

Why does the MPCA perform audits?

The MPCA performs audits on MS4 programs per the Environmental Protection Agency (EPA). The EPA requires routine audits to evaluate permittees for program compliance, best management practices, and identified performance goals. To meet this mandate, the MPCA has committed to completing approximately 33 MS4 program audits per year to ensure a timely and proper evaluation of each permittee.

Getting ready for an MS4 audit?

Try these tips to keep your MS4 program audit-proof.

  1. Conduct a mock audit. Use guidance documents from the MPCA and EPA to conduct a mock audit. Now is the time to identify potential areas of improvement before you’re faced with an actual MS4 audit.
  2. Plan ahead. Create a 12-month schedule for specific requirements to stay on track. For example, you should schedule MS4 inspection and training dates well in advance. You may also want to include publication deadlines to ensure any article submissions are delivered on time.
  3. Document everything. Documentation is your best ally in an audit scenario. Find a recordkeeping system that works and stick to it. And be sure to take credit for your work.
  4. Partner up. Why recreate the wheel? Consider partnering with other MS4s or local groups and share permit responsibilities. Otherwise, you can also utilize existing partnerships and discuss sharing responsibilities.
  5. Invest in your staff. Field staff are the first line of defense when it comes to protecting your MS4 system from illicit discharges. Ensure all field staff, including seasonal and contracted staff, are trained on the importance of their role in protecting water quality.

Meghan Litsey is a Senior Environmental Scientist on our environmental team with over eight years of experience. She specializes in providing environmental compliance services in construction site permitting, SWPPP design and inspection, and MS4 program development.

Creating a sustainable water reuse system for the Rochester Golf & Country Club

By Bob Barth, Director of Land Development, WSB

For over 100 years, the Rochester Golf & Country Club has been a fixture in its community. Since opening, land around the course developed, but the rolling greens of the Country Club still attract golfers as they did in the early 1900s when a group of avid golfers leased 100 acres from two Mayo Clinic doctors.

The Decorah Shale effect
The landscape 100 years ago was very different than it is today. As development occurred throughout the area, the course began to experience water issues. The course is located on the Decorah Shale Geologic Formation, an over 60-foot-thick layer of shale bedrock. Water passes through the impermeable shale layer slowly, causing drainage issues for many properties throughout southeastern Minnesota. In the case of the golf course, water is unable to penetrate the shallow shale layer located below the surface of the course, creating drainage issues and pockets of standing water on fairways and greens.

The most inexperienced golfer knows that standing water on a golf course leads to playability issues. At one point, there were playability issues on seven of the 18 holes – equating to 3,000 feet of playing conditions that had standing water or drainage problems. The County Club reached out to our team at WSB to find a sustainable solution to the chronic water issues that plagued the historic course.

Keeping greens, green
Golf courses use a lot of water and droughts or excess water negatively impact course profitability and sustainability. Like many Minnesota courses, Rochester Golf & Country Club uses groundwater for irrigation. However, the playability issues caused by the Decorah Shale are unique. Research and studies have criticized golf courses over the years for chemical and water use, particularly groundwater. Recently, many courses have taken strides to become more environmentally sensitive and eco-friendly. Rochester Golf & Country Club approached their golf course renovation project with sustainability in mind and decided to reuse the seepage water and surface water as a partial replacement for the groundwater they used for irrigation. This process allowed them to improve their environmental footprint.

Creating a solution out of the problem
WSB performed a rigorous rainfall and runoff analysis to determine the amount of available seepage and runoff water. The analysis included long-duration simulations of water yield and irrigation using state-of-the-art hydraulic modeling software. Every water reuse project is unique. Most of the land that Rochester Golf & Country Club sits on drains in a single direction, making it easier to capture seepage and runoff water. This efficiency of drainage created a single point of collection into a new irrigation pond.

After completing the reuse analysis, we worked with the Country Club and an irrigation design consultant to design the irrigation pond, pump station and pump house, the collection system to deliver water to the irrigation pond, and the outlet works from the pond to the public system. Drainage tile was placed under the fairway turf to allow water to feed into the irrigation pond. In the past, the Country Club used over 10 million gallons of groundwater for irrigation, annually. With the new water reuse and drainage system, the course’s groundwater usage dropped to 4 million gallons. The water reuse system can pump as much as 1,500 gallons per minute into the irrigation system. The reuse system also alleviates the need to tap into the city’s water supply and ensures that the course can stay watered even when conservation restrictions are in place.

Full-circle sustainability
The Rochester Golf & Country Club is dedicated to sustainability beyond water reuse and has established an on-site, 10,000-square-foot garden that supplies fresh produce to their executive chef. Additionally, the club is home to 400,000 honey bees, an effort to protect the honey bees’ declining population. Throughout the Country Club’s recent restoration, they have paid close attention to reusing available resources including creating benches out of downed trees and repurposing old cart path rock for new cart path base layers.

A fresh start in 2019
The course has been under construction since 2016 and reopened this spring. Under the direction of renowned golf course architect Tom Doak, the acclaimed 18-hole golf course went through a substantial renovation to restore the course to its original 1925 A.W. Tillinghast design.

Golf is a significant economic driver in Minnesota and water plays a vital role in keeping these courses busy throughout the golf season. In addition to our work on the Rochester Golf and Country Club, WSB has developed water reuse systems and measures for Oneka Ridge Golf Course in Hugo and Eagle Valley Golf Course in Woodbury.

Bob is a Principal at WSB with over 20-years of experience providing technical and management support to public and private clients. Bob’s special expertise in water resources management, infrastructure planning, project development, and land development make him an effective and trusted adviser on a variety of projects.

Drive safe

Between the increased number of travelers and the numerous road construction projects underway this summer, the Fourth of July is one of the most dangerous times to be on the roads in Minnesota. This year, there will be 70 different construction projects happening over the holiday, several of which are occurring on major highways from I-35W to I-94.

As a Director of Safety and Risk Management at WSB, it’s my job to ensure that we’re doing everything we can to keep drivers, their passengers and road crews safe when moving through a zone where our surveyors and engineers are working, from signage and lights to proper barricading. But there’s plenty you can do too, to ensure the safety of your family and those around you as you hit the road for the holiday.

Follow these tips

Make sure your vehicle can go the distance.
Swimsuit? Check. Sunscreen? Double check. You may have nailed your packing list, but your vehicle needs just as much attention. Make sure your tire pressure and tread are up to par, and that your spare tire is looking good too. And don’t forget to keep a break-down/emergency kit handy as well! This includes a jack and tools for any flats or blow outs that may occur.

Plan ahead.
Knowing whether there is road construction on your route is important. The Minnesota Department of Transportation (MnDOT) posts all construction projects on its website, and most map applications should be up to date with the latest detours and lane closures.

Stay alert.
Don’t count on coffee to keep you vigilant while driving. You may be itching to get to your destination, but make sure you take regular breaks and get at least eight hours of sleep before hitting the road.

Adjust your speed.
Speed is the number one cause of accidents and fatalities in construction zones. Move over for parked emergency or maintenance vehicles, and slow down to 20-miles-per-hour when passing.

Practice defensive driving.
It may take a bit of a driver’s ed refresh, but defensive driving is key. Accidents in construction zones are often a result of drivers having little or no reaction time, leading to rear-end collisions. Avoid distractions, cell phones or passengers who are taking your attention from the roadway. Allow plenty of stopping distance between your vehicle and the vehicle in front of you, a minimum of two car lengths.

Do NOT drive impaired.
It seems obvious but driving while under the influence is a leading cause of death in construction zones, second only to speed. If you choose to indulge on your holiday travels, be sure to have a designated driver.

As we all look forward to the fun this holiday will bring, keep these tips in mind. This simple list could be the difference between getting to the fun safely, and not getting there at all.

Jason Daugherty is the Director of Safety and Risk Management on our construction team with over 20 years of experience performing safety management in construction, pipeline, aviation, DOT, environmental, and incident and accident investigation.

By Ryan Spencer, Senior Environmental Scientist

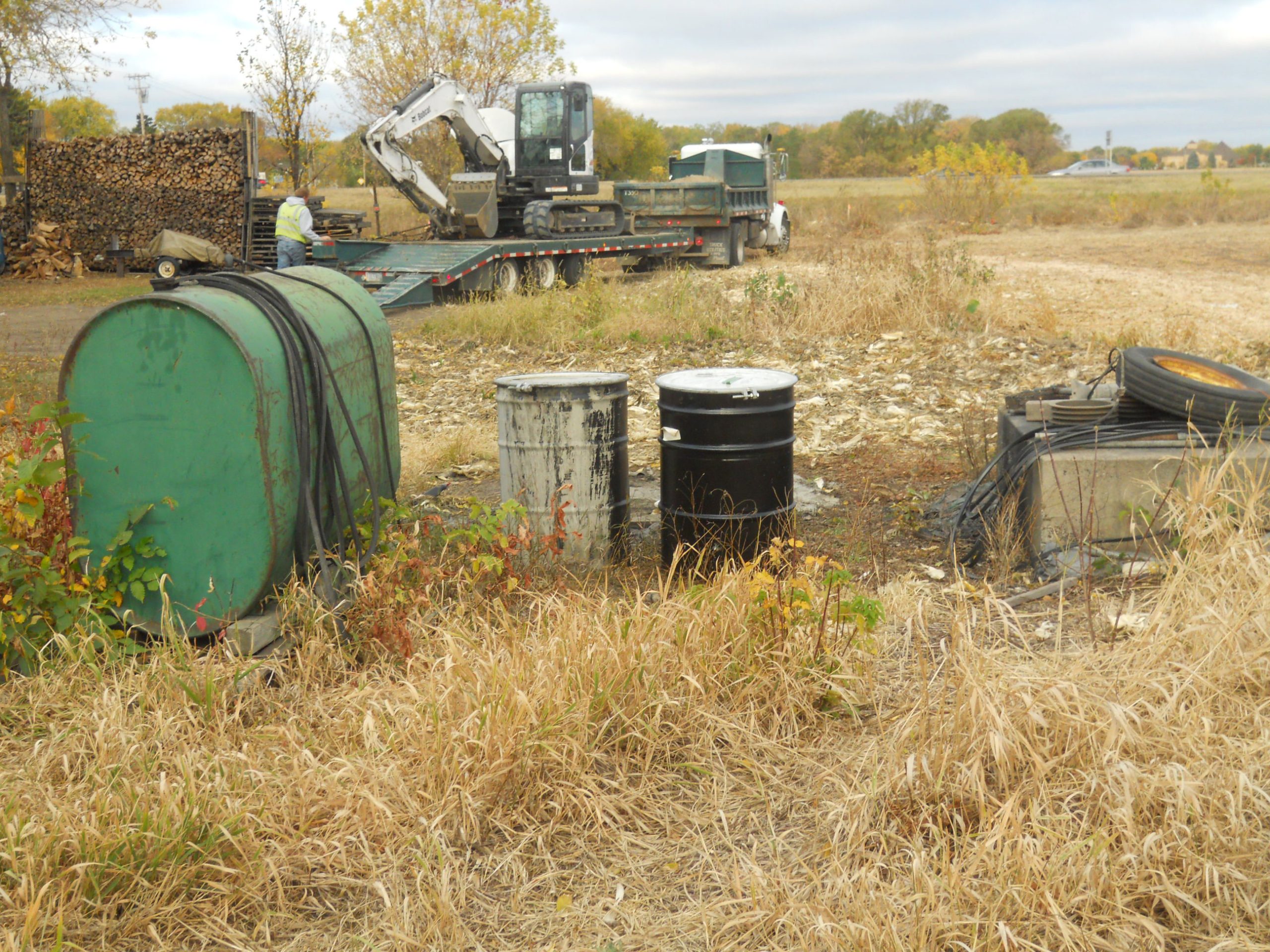

The term “brownfield” describes property that has the presence or potential presence of hazardous materials, pollution, or contamination. Generally, brownfields consist of current or former industrial, manufacturing, or recycling sites that are vacant and underutilized by the community. However, they can also include current/former gas stations or drycleaner sites located in residential neighborhoods. Brownfield sites are often an eyesore and contain dilapidated buildings, poorly kept grounds, and miscellaneous trash. Cities usually obtain ownership of brownfield sites through tax forfeiture which causes concern due to unknown environmental risks and pressure to redevelop. Rather than viewing a brownfield site as a liability, experienced cities and developers see them as an opportunity.

In recent years, brownfield redevelopment has become more common due to infill redevelopment and the shortage of developable land in urban areas. Through up-front work and investments, communities can take steps to ensure their brownfields are attractive to developers and ready for redevelopment. Additionally, there are numerous investigation and cleanup funding sources available along with additional avenues to obtain liability assurances, which help curb redevelopment costs and reduce contamination liability.

Do your due diligence
Performing environmental due diligence on a brownfield site uncovers potential environmental risks and contamination liabilities. Investing in the upfront due diligence is an important step in any successful redevelopment project. Typically, this is achieved by completing a Phase I Environmental Assessment (ESA), subsequent Phase II ESA (if warranted), and an Asbestos and Regulated Materials Survey on buildings (if present). The potential environmental risks are always scarier than actual risks. Once the environmental risk area is understood, the site is one step closer to redevelopment.

How do I fund this?
Investigation and cleanup funding are critical components of brownfield projects. If you don’t have the money, where do you start? There are many local, state, and federal funding sources available for brownfield projects in Minnesota. This is great, but can also be overwhelming. It’s important to understand the funding source application requirements, schedule, and scoring criteria. Funding is typically awarded in cycles (often biannually), resulting in vigorous competition among projects. The projects that best meet the funding source’s criteria will be awarded funding.

Upcoming funding opportunities
In Minnesota, two major investigation/cleanup funding sources include:

Minnesota Department of Employment and Economic Development (DEED) Contamination Cleanup and Redevelopment Grants – Applications Due May 1 and November 1 each year.

These grants are available to both public and private redevelopment sites and can be used for environmental investigation and/or cleanup. Applications are eligible if known or suspected soil or groundwater contamination is present. Key scoring criterion include; creating and retaining jobs and affordable housing.

Additional information regarding DEED funding can be found at:  https://mn.gov/deed/government/financial-assistance/cleanup/contamination.jsp

Metropolitan Council Tax Base Revitalization Account (TBRA) – Applications Due November 1 each year.

TBRA provides $5 million annually to investigate and clean up brownfields for public and private redevelopment sites. The funding is limited to sites located within the 7-county Twin Cities metro region and key scoring criteria include; increasing tax base, preserving livable wage jobs, and producing affordable housing.

Additional information regarding TBRA funding can be found at:  https://metrocouncil.org/Communities/Services/Livable-Communities-Grants/Tax-Base-Revitalization-Account-(TBRA).aspx

Brownfields – a path to prosperity
A successful brownfield redevelopment can have a substantial impact on a community. It spurs economic momentum while showing commitment to continuous city improvements. Surly Brewing in Minneapolis was once a blighted underutilized property and is now a booming social attraction with rapid development occurring around it. Similarly, Kaposia Landing in South St. Paul – a popular waterfront park and recreation area – was once a landfill with little to no community value.

The next time you drive by a vacant underutilized property, think of what could be. Chances are, you are not the only one who has a vision of the site being repurposed, revitalized, and an asset to the community.

Ryan Spencer is a Sr. Environmental Scientist on WSB’s Environmental team. His expertise extends to Phase I & II Environmental Site Assessments, construction soil screening and documentation, contamination disposal and other hazardous material mitigation. He consults closely with both public organizations and private developers on their environmental needs.
